Earned Value Management (EVM): A Simple Guide

T.Beswifty 106 views
Earned Value Management (EVM): A Simple Guide

Earned Value Management (EVM): A Simple Guide

Hey guys! Ever felt like you’re throwing money into a project and have no clue if you’re on track? Or maybe you’re drowning in spreadsheets, trying to figure out if you’re actually getting your money’s worth? Well, that’s where Earned Value Management (EVM) comes to the rescue! Think of it as your project’s financial GPS, helping you navigate through costs, schedules, and performance like a pro.

What Exactly is Earned Value Management (EVM)?

Earned Value Management (EVM) is a project management technique that combines measurements of the project’s scope, schedule, and costs. It’s a way to assess project performance by comparing what you’ve actually achieved with what you planned to achieve. Basically, it tells you whether you’re ahead, behind, or right on schedule and budget. So, instead of just guessing or relying on gut feelings, EVM gives you hard data to make informed decisions. It’s like having a crystal ball that shows you the future of your project – if you know how to read it!

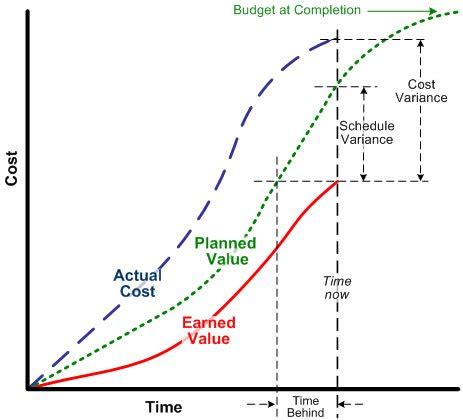

At its core, EVM tracks three key values : Planned Value (PV), Actual Cost (AC), and Earned Value (EV). Planned Value (PV) , sometimes called the Budgeted Cost of Work Scheduled (BCWS), is the authorized budget assigned to the work scheduled to be completed for a task or project component. This represents the planned cost of work that should have been accomplished by a specific point in time. Actual Cost (AC) , also known as Actual Cost of Work Performed (ACWP), is the total cost actually incurred in completing the work. This includes all direct and indirect costs. Earned Value (EV) , or Budgeted Cost of Work Performed (BCWP), is the value of the work actually completed. It’s the budget associated with the completed work. Basically, it tells you how much of the budget you’ve “earned” based on the work you’ve finished. By comparing these values, EVM provides insights into schedule and cost performance.

EVM is not just about tracking numbers; it’s about proactive project control. It allows project managers to identify potential problems early on and take corrective actions to keep the project on track. For example, if the EV is lower than the PV, it indicates that the project is behind schedule. Similarly, if the AC is higher than the EV, it indicates that the project is over budget. By monitoring these variances, project managers can make informed decisions about resource allocation, risk management, and scope changes. EVM also promotes better communication among stakeholders by providing a clear and objective measure of project performance. This ensures that everyone is on the same page and understands the project’s progress and challenges. In short, EVM provides a comprehensive framework for managing project performance and delivering successful outcomes. It’s an invaluable tool for any project manager looking to improve project control and achieve project goals.

Why Should You Care About EVM?

Okay, so EVM sounds fancy, but why should you actually bother using it? Well, for starters, it gives you early warnings . EVM helps you spot potential problems way before they turn into full-blown disasters. Think of it as your project’s early warning system, alerting you to potential delays or budget overruns. This gives you time to take corrective actions and get things back on track before it’s too late. No one wants to be blindsided by unexpected costs or missed deadlines, and EVM helps you avoid those nasty surprises. Early warnings translate to more control, less stress, and happier stakeholders. Moreover, it allows for better decision-making. Instead of relying on guesswork, EVM provides you with hard data to make informed decisions. This means you can allocate resources more effectively, adjust your project plan as needed, and make smart choices that will ultimately lead to project success. Data-driven decisions are always better than gut feelings, especially when it comes to managing complex projects. EVM empowers you to make those decisions with confidence.

EVM also helps improve communication . Let’s be real; project communication can be a nightmare. EVM provides a common language for everyone involved in the project, from team members to stakeholders. When everyone understands the project’s performance metrics, it’s easier to have productive conversations and resolve issues. No more misunderstandings or conflicting reports – EVM ensures that everyone is on the same page. This leads to better collaboration, stronger relationships, and a more cohesive project team. Furthermore, EVM increases accountability . By tracking performance against a baseline, EVM holds team members accountable for their work. This encourages everyone to take ownership of their tasks and strive for excellence. Accountability leads to improved performance, higher quality deliverables, and a greater sense of responsibility among team members. When everyone is accountable, the project is more likely to stay on track and achieve its goals. Basically, EVM is a super useful tool that can seriously up your project management game!

And let’s not forget about the long-term benefits. By consistently using EVM, you can build a historical database of project performance. This data can be used to improve future project planning and estimating. You’ll learn from past mistakes, identify best practices, and continuously refine your project management processes. This leads to more accurate estimates, more realistic schedules, and better project outcomes. Over time, EVM can transform your organization’s project management capabilities, making you more efficient, more effective, and more successful. So, if you’re serious about project management, EVM is a tool you can’t afford to ignore.

The Core Components of EVM

Alright, let’s break down the key ingredients of the EVM recipe. You’ve got three main players here: Planned Value (PV), Actual Cost (AC), and Earned Value (EV). Think of them as the holy trinity of project performance tracking.

Planned Value (PV)

Planned Value (PV) , sometimes called the Budgeted Cost of Work Scheduled (BCWS), is the authorized budget assigned to the work scheduled to be completed for a task or project component. This represents the planned cost of work that should have been accomplished by a specific point in time. Basically, it’s how much you planned to spend by now. It’s like your project’s financial roadmap, showing you where you should be in terms of spending at any given moment. Without a clear PV, it’s impossible to know if you’re on track or falling behind. It provides a baseline against which you can measure your actual performance and identify variances early on. A well-defined PV is essential for effective project control and successful project outcomes.

To calculate the PV , you need to break down your project into smaller tasks, estimate the cost of each task, and then schedule those tasks over time. The PV is the sum of the budgeted costs for all tasks that are scheduled to be completed by a specific date. For example, if you have a project with ten tasks, and the first three tasks are scheduled to be completed by the end of the month, the PV for the end of the month would be the sum of the budgeted costs for those three tasks. It’s important to note that the PV should be based on a realistic and achievable schedule. If the schedule is too aggressive, the PV will be artificially high, and it will be difficult to achieve the planned targets. Therefore, careful planning and realistic scheduling are crucial for establishing an accurate and meaningful PV. In project management, a solid Planned Value is the bedrock of being able to track what you should have spent by a particular time.

Actual Cost (AC)

Actual Cost (AC) , also known as Actual Cost of Work Performed (ACWP), is the total cost actually incurred in completing the work. This includes all direct and indirect costs. This is how much you actually spent. This includes everything – labor, materials, equipment, and any other expenses related to the project. Tracking AC accurately is essential for effective cost management and project control. Without knowing how much you’re actually spending, it’s impossible to identify cost overruns or areas where you can save money. The AC provides a clear picture of the project’s financial performance and allows you to make informed decisions about resource allocation and cost control. Accurate tracking of Actual Cost (AC) keeps your project grounded in financial reality, showing exactly what has been spent.

To calculate the AC, you need to track all project-related expenses and allocate them to the appropriate tasks. This can be done using accounting software, spreadsheets, or other cost-tracking tools. It’s important to capture all costs, including both direct and indirect expenses. Direct costs are those that are directly attributable to the project, such as labor and materials. Indirect costs are those that are not directly attributable to the project but are necessary for its completion, such as overhead and administrative expenses. Once you have tracked all project-related expenses, you can sum them up to calculate the AC. The AC should be tracked regularly, preferably on a weekly or monthly basis, to ensure that you have an up-to-date view of the project’s financial performance. Regular monitoring of AC allows for quick identification of variances and timely corrective actions.

Earned Value (EV)

Earned Value (EV) , or Budgeted Cost of Work Performed (BCWP), is the value of the work actually completed. It’s the budget associated with the completed work. Basically, it tells you how much of the budget you’ve “earned” based on the work you’ve finished. The Earned Value (EV) reflects the real progress of your project in monetary terms.

To calculate the EV, you need to determine the percentage of work completed for each task and then multiply that percentage by the task’s budgeted cost. For example, if you have a task with a budgeted cost of \(1,000 and you have completed 50% of the work, the EV for that task would be \) 500. The EV represents the value of the work that has been completed, regardless of how much it actually cost to complete that work. It’s a measure of the project’s performance against the planned schedule and budget. The EV should be tracked regularly, along with the PV and AC, to provide a comprehensive view of the project’s performance. Regular tracking of EV helps in assessing efficiency and effectiveness in project execution.

Key EVM Formulas You Should Know

Alright, now that we’ve got the basics down, let’s dive into some of the key formulas that make EVM tick. These formulas will help you analyze your project’s performance and make informed decisions.

  • Schedule Variance (SV) = EV - PV : This tells you whether you’re ahead or behind schedule. A positive SV means you’re ahead, while a negative SV means you’re behind. Essentially, SV measures how far ahead or behind the planned schedule the project is.
  • Cost Variance (CV) = EV - AC : This tells you whether you’re over or under budget. A positive CV means you’re under budget, while a negative CV means you’re over budget. In essence, CV indicates how much the actual costs deviate from the earned value.
  • Schedule Performance Index (SPI) = EV / PV : This is a measure of schedule efficiency. An SPI greater than 1 means you’re ahead of schedule, while an SPI less than 1 means you’re behind schedule. SPI provides a ratio that indicates the efficiency of the project’s schedule performance.
  • Cost Performance Index (CPI) = EV / AC : This is a measure of cost efficiency. A CPI greater than 1 means you’re under budget, while a CPI less than 1 means you’re over budget. The CPI offers a ratio that reflects the efficiency of the project’s cost management.

By using these formulas, you can get a clear picture of your project’s performance and identify areas that need attention. Remember, EVM is all about using data to make informed decisions and keep your project on track. These formulas are your analytical tools for data-driven decision-making.

EVM in Action: An Example

Let’s say you’re building a website. Your initial plan looks like this:

  • Planned Value (PV) : By the end of week 4, you planned to spend $10,000.
  • Actual Cost (AC) : At the end of week 4, you actually spent $12,000.
  • Earned Value (EV) : At the end of week 4, you completed work worth $8,000.

Now, let’s calculate the variances and indexes:

  • Schedule Variance (SV) : \(8,000 - \) 10,000 = -$2,000 (You’re behind schedule)
  • Cost Variance (CV) : \(8,000 - \) 12,000 = -$4,000 (You’re over budget)
  • Schedule Performance Index (SPI) : \(8,000 / \) 10,000 = 0.8 (You’re 80% efficient in terms of schedule)
  • Cost Performance Index (CPI) : \(8,000 / \) 12,000 = 0.67 (You’re 67% efficient in terms of cost)

Based on these numbers, you can see that your project is both behind schedule and over budget. You need to take corrective actions to get things back on track. This might involve reallocating resources, adjusting the project schedule, or cutting costs. By using EVM, you can identify these problems early on and take steps to address them before they become major issues. EVM helps you catch small problems before they become big headaches.

Tips for Implementing EVM Successfully

Okay, so you’re sold on EVM, but how do you actually make it work in the real world? Here are a few tips to help you implement EVM successfully:

  • Start with a solid plan : EVM is only as good as your initial project plan. Make sure you have a clear scope, realistic schedule, and accurate budget. A flawed plan will lead to flawed EVM results. The better the plan, the more effective your EVM.
  • Track your costs meticulously : Accurate cost tracking is essential for EVM. Make sure you capture all project-related expenses and allocate them to the appropriate tasks. Use accounting software or other cost-tracking tools to simplify the process. Solid data in means solid data out, and better project control.
  • Update your data regularly : EVM is an ongoing process, not a one-time event. Update your data regularly, preferably on a weekly or monthly basis, to ensure that you have an up-to-date view of the project’s performance. Don’t let your EVM data get stale or you’ll lose its value.
  • Communicate your findings : EVM is not just for project managers. Share your findings with the entire project team and stakeholders. This will help everyone understand the project’s performance and make informed decisions. The more everyone knows, the better they can do their jobs, and the more likely the project will be to succeed.

EVM: Not Just for Big Projects

One common misconception is that EVM is only for large, complex projects. While it’s true that EVM can be particularly useful for managing big initiatives, it can also be applied to smaller projects. The key is to tailor the level of detail to the size and complexity of the project. For smaller projects, you might simplify the process by focusing on the most critical tasks and metrics. You don’t need to track every single expense or calculate every possible variance. Just focus on the key indicators that will give you a good sense of the project’s overall performance. Even on a small scale, EVM can help you stay on track, avoid budget overruns, and deliver successful outcomes. The scalability of EVM makes it a versatile tool for projects of all sizes.

Final Thoughts

Earned Value Management (EVM) might sound intimidating at first, but it’s a powerful tool that can help you take control of your projects. By tracking your planned value, actual costs, and earned value, you can get a clear picture of your project’s performance and make informed decisions. So, ditch the guesswork and embrace the power of EVM! Your projects (and your sanity) will thank you for it.
